How to Build a Deck Over a Concrete Patio in San Antonio

How To Build A Deck Over A Concrete Patio
Build a deck over concrete patio slabs in San Antonio: floating vs attached frames, slab prep, sleepers, flashing, the 200 sq ft permit rule, and costs.
Concrete Guide · San Antonio, TX

Your old patio can carry a new deck, but only if the concrete is ready for it. This guide shows how to build a deck over concrete patio slabs in San Antonio: when to float the frame and when to attach it, how to prep the slab on our clay soil, which fasteners and flashing to use, what the city requires, what it costs, and how to keep the deck in shape.

Updated October 2026 · Reviewed by Ted, Owner · 13-minute read
Quick Answer

Yes, if the slab is sound. Most low decks float on treated or composite sleepers set over a moisture barrier, on a slab that falls about 1/4 inch per foot away from the house. San Antonio clay soil moves slabs, so have the concrete checked first if cracks are wider than 1/4 inch or sections have sunk.


Can you build a deck over a concrete patio?

Yes. A sound concrete slab makes a flat, solid base for a low deck, so you can skip digging footings and tearing out the old patio.

The key word is “sound.” A low deck follows the slab under it. If the patio is level, sheds water away from the house, and is not moving, a deck over it can last for years. If the slab is sinking, cracked through, or holding water, the deck inherits every one of those problems, just out of sight.

That is why the order matters: fix the concrete first, get a written plan for the slab, then hire the deck builder. The rest of this guide follows that order.


Should the deck be attached to the concrete or float on it?

For most San Antonio patios, a floating frame is the safer choice: sleepers rest on the slab and are only lightly anchored, and the deck is not tied to the house. Attach the frame firmly to the slab only when the slab is sound and stable, and tie a deck to the house only with a code-built ledger and a permit.

OptionHow it worksBest whenWatch out for
Floating sleeper frameSleepers sit on the slab over a barrier, held with a few anchors or by their own weight and blockingLow decks, slabs with minor movement, freestanding designsMust stay level as clay soil shrinks and swells; check it yearly
Sleepers anchored to the slabSleepers fastened every 16 to 24 inches with concrete screws or anchorsSound, level slab with no active cracksA slab that moves will rack the frame and pull fasteners
Deck attached to the house (ledger)One side bolts to the house rim board; the other side rests on the slab or footingsTaller decks or designs that run to the back doorNeeds a permit in San Antonio, correct flashing, and structural attachment

On expansive clay, a patio slab and a house foundation can move differently. A deck rigidly tied to both can bind or crack where they meet, which is one more reason most low decks over patios are built freestanding.


How do I know my patio is ready for a deck?

A slab is usually ready if it is level within small dips, drains away from the house, has no cracks wider than 1/4 inch, and stays dry under a plastic sheet for a day. If any of those fail, the concrete needs work before the deck goes on.

  • Cracks: Our patio maintenance guide treats cracks under 1/8 inch as cosmetic, 1/8 to 1/4 inch as monitor-and-fill, and anything wider than 1/4 inch, or with one side higher than the other, as a sign of soil movement that needs a professional look.
  • Level: Lay a straight 8-foot board across the slab. Small dips can be shimmed. Sections that have dropped an inch or more need repair or leveling first.
  • Drainage: Hose the slab or check it after rain. Water should run away from the house, not pool by the wall or under the door.
  • Moisture: Tape a square of plastic to the slab for 24 hours. Fog or droplets under it mean moisture is coming up, so the sleepers need a barrier and airflow.
  • Door height: Measure from the slab to the bottom of the door threshold. Sleepers plus deck boards add height, and the finished deck has to stay below the threshold so rain does not run inside.

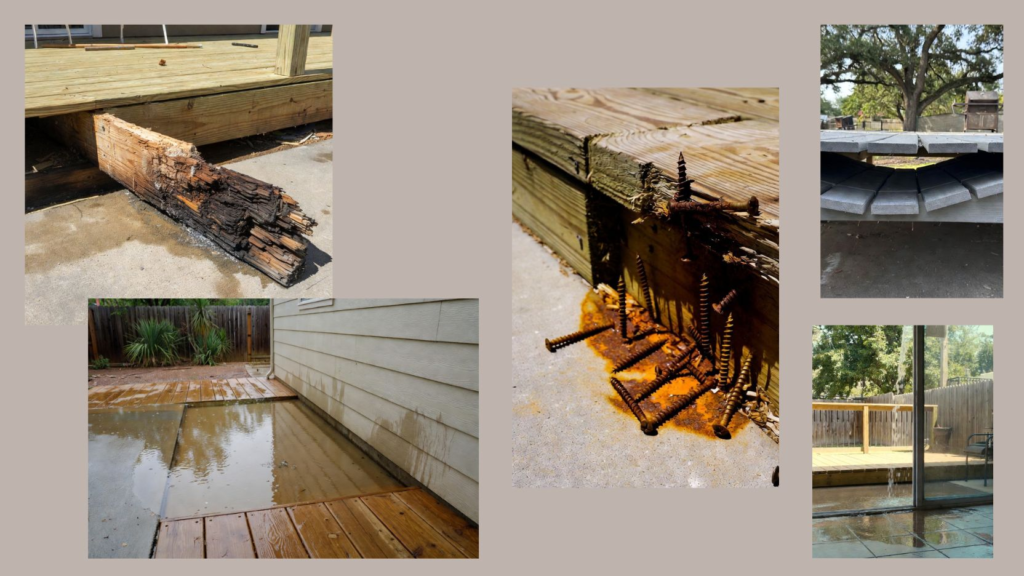

Fix the slab first if you see
  • Cracks wider than 1/4 inch or still growing
  • One side of a crack higher than the other
  • Sunken sections or a tilt toward the house
  • Water standing on the slab a day after rain

Do not cover these with a deck. Call (713) 504-2341 for a free look at the slab before you buy lumber.


How do you prepare a concrete patio for a deck?

Repair or level the slab, deal with the joints, correct the drainage, then clean it and plan for airflow under the boards. This prep is concrete work, and it decides how long the deck lasts.

  1. Repair and level: Fill stable cracks with a flexible filler, and have sunken or tilted sections cut out and repoured or leveled. Our patio repair service covers cracks, sunken sections, and drainage. A thin dip can sometimes be corrected with patio resurfacing instead.
  2. Cut and patch where needed: Badly broken sections can be saw-cut out and patched with new concrete so the deck has a continuous base. If an old slab has random cracking and no control joints, a crew can saw-cut joints to guide future cracks to planned lines.
  3. Plan around the joints: Slab sections on each side of a joint can move separately. Avoid locking one long sleeper rigidly across a joint; break it at the joint or anchor it on one side only, and leave the joint along the house open.
  4. Fix the slope: Our patio slope guide uses about 1/4 inch of fall per foot away from the house, so a 12-foot patio drops about 3 inches. Pitch cannot be added to cured concrete without grinding, an overlay, or a repour, so settle this before framing.
  5. Clean and dry: Pressure wash the slab, remove moss and old sealer flakes, and let it dry fully before any barrier or tape goes down.
  6. Plan drainage and ventilation: Run sleepers in the direction water flows so they do not act like dams, and leave openings at the deck edges so air can move under the boards.

Not sure whether the slab is worth saving? Read should I repair or replace my concrete patio? before you pay for decking.


How do you attach sleepers and framing to concrete?

Use rot-resistant sleepers, set them 12 to 16 inches on center or as the board maker requires, shim with composite shims, and fasten with masonry screws or anchors rated for exterior use. Every fastener in treated lumber should be hot-dipped galvanized or stainless steel.

PartWhat to useTip
Sleepers2×4 or 2×6 lumber treated for ground contact, or composite or aluminum sleepersLay 2x4s flat for the lowest profile when the door height is tight
Concrete screwsCoated masonry screws in pre-drilled holesGood for low, light sleeper frames on a sound slab
Wedge or sleeve anchorsStainless or hot-dipped galvanized anchorsFor heavier frames, perimeter rims, or posts on the slab
Post basesGalvanized standoff post bases anchored to the slabKeeps post ends off the wet concrete
ShimsComposite or plastic shimsWood shims rot under a deck
Board fastenersStainless or coated deck screws, or the board maker’s hidden clipsComposite warranties often require the maker’s own system

Drill with a hammer drill and a masonry bit sized to the fastener, blow the dust out of each hole, and keep anchors back from slab edges and cracks so the concrete does not spall. Never drill into a slab that may hide plumbing or electrical lines without checking first.


How do you waterproof and flash a deck over concrete?

Keep wood off bare concrete with a barrier under every sleeper, cover the tops of wood sleepers with joist tape, and flash any ledger where a deck meets the house. Water that cannot drain or dry out is what rots a low deck.

  • Under the sleepers: Lay membrane strips or flashing tape between the slab and each wood sleeper so it never sits in a film of water.
  • On top of the sleepers: Butyl joist tape over the sleeper tops sheds water that drips through the board gaps and seals around screw holes.
  • At the house: If a deck is attached, the ledger needs flashing that laps under the siding or weather barrier and over the ledger, so water is steered out, not into the wall. Ledgers bolt to the house framing, not to brick or stone veneer.
  • At the door: Keep the finished deck below the threshold, and do not bury door sills or weep holes behind boards.
  • Gaps and airflow: Leave the board gaps the maker lists and open edges for air. A low deck boxed in tight traps heat and moisture.

San Antonio’s adopted residential code covers deck framing, ledgers, and flashing in IRC Section R507, and the City’s deck bulletin points builders to that section and the American Wood Council DCA 6 guide. Your deck builder should work from those, or from an engineer’s design.


Do you need a permit for a deck over a patio in San Antonio?

Sometimes. The City of San Antonio says you do not need a building permit only if your deck meets all four of these: no more than 200 square feet, no more than 30 inches above grade at any point, not attached to the house, and not serving the exit door of the house.

  • The two City sources differ: Development Services’ homeowner FAQ uses the four-part test above, while Information Bulletin 151 (revised May 2025) says a deck needs a permit when it exceeds 300 square feet or is more than 30 inches above grade. When they disagree, plan on the stricter four-part test and confirm with Development Services at 210-207-1111.
  • How to apply: One-story decks of 1,000 square feet or less use the Residential Improvements Permit Application in the BuildSA portal. IB 151 says approval normally comes within one to two days, with possible zoning or historic review depending on the address.
  • Inspections: For decks under 48 inches above grade, the City inspects foundation and framing (or accepts an engineer or architect letter) and does a final inspection.
  • Who can apply: A homeowner can apply for a deck permit and certify they will live in the home more than 12 months. If you plan to sell the home soon, IB 151 says a contractor must apply instead.
  • Extras: Lighting, outlets, or plumbing on the deck need separate trade permits, pulled by trade contractors registered with the City. Homes in Historic, Neighborhood Conservation, or Corridor Districts may face design limits, and an HOA can add its own approval.

Separate cities inside the San Antonio area, such as Alamo Heights, Leon Valley, and Helotes, set their own rules, so call your city if your address is outside San Antonio city limits.


How much does it cost to build a deck over a concrete patio?

The total is two bills: the concrete work to get the slab ready, and the deck builder’s price for framing and boards. We put the concrete part in writing after a free site visit, and you should get the deck part in writing from the deck builder.

ItemPublished figureSource
DIY filler for hairline cracksAbout $10 to $25 in materialsPatio maintenance guide
Patio repair, cutting, patching, or levelingNo published price; quoted in writing after a free lookPatio repair cost guide
Tearing out failed concreteAbout $1.50 to $3.00 per square footConcrete replacement cost guide
New standard concrete patio, if the old one cannot be savedAbout $6 to $12 per square foot; $1,800 to $3,600 for 300 square feetPatio installation cost guide
Deck framing and boardsNot published by us; get a written bid from the deck builderYour deck contractor
City permit, if requiredFees set by the City at applicationCity IB 151

Figures from our own San Antonio cost guides, checked October 29, 2026. They are typical ranges, not a quote.

What changes the price

  • How much of the slab needs repair, leveling, or a repour
  • Access to the backyard for equipment and haul-off
  • Deck size, shape, steps, and whether it attaches to the house
  • Board choice: treated pine, cedar, or a composite line
  • Permit, inspections, and any engineer letter
Deck over concrete at a glance

The slab decides how long the deck lasts

Slab slope
1/4 in. per ft
Away from the house
Crack warning sign
Over 1/4 in.
Repair before you build
Sleeper spacing
12 to 16 in.
Or what the board maker lists
No-permit limit
200 sq. ft.
Plus 30 in. high, freestanding, not at an exit door
Moisture test
24 hours
Plastic sheet taped to the slab
Concrete estimate
Free, in writing
Before any work starts

How long does a deck over a concrete patio take?

Plan for three stages: the slab visit and written estimate, any concrete repair plus curing time, then the deck build itself. A sound slab that needs no work lets the deck builder start right away.

  • Site visit and estimate: Request one by phone or online. Our online estimates guide explains what to send and what happens next.
  • Concrete repair or repour: Patches and repours need time to cure before anchors go in. Our maintenance guide uses 28 days as full cure for new concrete before sealing, so ask the crew when the slab can be drilled.
  • Permit: If one is needed, IB 151 says small-deck applications are normally approved within one to two days, plus time for inspections.
  • Deck build: Ask the deck builder for a written start and finish date.

How do San Antonio clay soil and heat affect a deck over concrete?

Expansive clay under many San Antonio patios swells when wet and shrinks when dry, so slabs can crack or tilt, and a deck on top moves with them. Long, hot summers also bake deck boards and shorten the life of wood finishes.

  • Late-summer movement: Our maintenance guide notes that clay shrinks during the August and September dry spell, so a patio that looked fine in May can show new cracks by fall. Check the slab after that season before you build.
  • Drainage is the defense: Water that sits beside the slab keeps the clay moving. Keep the slope, clear gutters, and do not let downspouts empty under the deck.
  • Heat on boards: Dark composite can get very hot in full sun. Leave a sample outside for an afternoon and pick a lighter color for open patios.
  • Pests and moisture: Wood near the ground faces rot and termites. Ground-contact lumber, barriers, and airflow all help.

Weighing a deck against a concrete upgrade? Our guide concrete patio vs wood deck: which lasts longer? compares lifespan and upkeep in Texas weather.


How do you maintain a wood or composite deck over concrete?

Keep the gaps and the slab underneath clear so water and air can move, clean the boards, and refinish wood on a schedule. Composite skips the sealing but still needs cleaning and airflow.

TaskWood deckComposite deck
Clean the boardsWash and scrub; let it dry fullySoap and water or the maker’s cleaner
Seal or stainRefinish when water stops beading; sun and heat wear finishes faster hereNot needed
Clear the gapsRemove leaves and live oak debris so water drainsSame; trapped debris holds moisture
Check fastenersReset popped screws and look for soft or split boardsCheck clips and board ends for movement
Check the slabLook under the edges after heavy rain for pooling or new cracksSame

Our patio vs deck guide puts most Texas wood decks at about 10 to 20 years, depending on wood type, moisture, sun, and upkeep.


Who should handle the concrete before the deck builder starts?

A concrete contractor, before you sign with a deck builder. Most deck crews build on whatever slab they are given, so the inspection, cutting, patching, leveling, and slope work should be done and priced first.

Here is how Affordable Concrete San Antonio fits in:

  • Free site inspection of the slab, cracks, slope, and drainage
  • Saw-cutting and patching broken sections, or a repour where the slab has failed
  • Leveling sunken areas and correcting the fall away from the house
  • Setting a sleeper base on the prepared slab when you want the concrete side handled in one job
  • A clear written estimate before any work starts, so you know the concrete cost before you hire a deck contractor

Insured, with $2,000,000 in liability coverage. See our patio deck construction page for how the visit works, or start with our main concrete patio in San Antonio service page.

Getting your patio ready for a deck?

Free look at the slab, the concrete price in writing before work starts, and a crew insured with $2,000,000 in liability coverage.


Where do we work?

Affordable Concrete San Antonio works across San Antonio and nearby areas from our shop at 1247 W Thompson Pl, San Antonio, TX 78226.

Our patio deck construction page lists San Antonio plus Helotes, Leon Valley, Shavano Park, Terrell Hills, Alamo Heights, Converse, Universal City, Schertz, Boerne, Cibolo, Fair Oaks Ranch, Bulverde, Spring Branch, New Braunfels, Pleasanton, Floresville, Castroville, Lytle, and Von Ormy. Not sure about your address? Call (713) 504-2341.


What else are homeowners asking?

These are the short answers people want before they book a quote.

Can you build a deck over a concrete patio?

Yes, if the slab is level, drains away from the house, and is not moving. Sleepers set over a moisture barrier carry the deck boards.

Should a deck over concrete be attached to the house?

Usually not. Most low decks over a patio float on sleepers. Attaching one to the house needs a flashed ledger bolted to the framing and, in San Antonio, a building permit.

How far apart should sleepers be on a deck over concrete?

Usually 12 to 16 inches on center. Composite boards and diagonal layouts often need the tighter spacing, so follow the board maker guide.

Do I need a permit for a deck over a patio in San Antonio?

The City says no permit is needed only if the deck is 200 square feet or less, no more than 30 inches high, not attached to the house, and not serving an exit door. Call 210-207-1111 to confirm.

How much does a deck over a concrete patio cost?

It is two prices: the concrete prep and the deck build. We quote slab repair and leveling in writing after a free visit, and the deck builder prices the framing and boards.

Should I fix my concrete patio before building a deck?

Yes. Cracks wider than 1/4 inch, sunken sections, or water pooling against the house should be repaired first, because the deck will move with the slab.

Written and reviewed by
Ted
Owner · Affordable Concrete San Antonio

Affordable Concrete San Antonio is a father-son concrete company in San Antonio. Ted updated this guide on October 29, 2026, and checked it against our patio service pages, our own cost guides, and the City of San Antonio deck permit guidance.

Sources used in this article:

  • City of San Antonio Development Services, Getting Started FAQ, “Do I need a permit to build a deck?”, checked October 29, 2026, sa.gov
  • City of San Antonio Development Services, Information Bulletin 151, Residential Deck Permits (revised May 2025), checked October 29, 2026, docsonline.sanantonio.gov
  • City of San Antonio, No Permit Required List (district restrictions note), checked October 29, 2026, sa.gov
  • Affordable Concrete San Antonio cost and patio guides (patio installation cost, concrete replacement cost, patio maintenance, patio slope), checked October 29, 2026, affordableconcretesanantonio.com
  • Affordable Concrete San Antonio, patio deck construction service page, checked October 29, 2026, affordableconcretesanantonio.com/concrete-patio-san-antonio/deck-construction/

This article is general information for San Antonio homeowners. Prices are typical ranges from our own guides and can change. It is not a quote, not engineering advice, and does not replace an on-site look at your patio or a check with your city.
