A commercial pool deck build in San Antonio is a different animal than a residential pour. Stricter codes, ADA requirements, heavier load specs, and a multi-phase approval process all come into play before a single yard of concrete is ordered. This guide walks you through every stage so your project runs on schedule and on budget.

Commercial pool deck San Antonio New pool deck build SA Timeline · Cost guide · Code requirements Hotels · Apartment Complexes · HOAs · Rec Centers Updated 2026
A
Affordable Concrete San Antonio Editorial Team
With over 10 years of residential and commercial concrete experience in San Antonio and the surrounding areas, our team has completed thousands of driveways, patios, pool decks, and commercial slabs across Bexar County. Every guide we publish reflects real on-the-ground expertise not generic contractor advice.
· affordableconcretesanantonio.com · Licensed & Insured · $2M Liability Coverage
Read our complete pool deck guide
Expansion Joints: Protecting Pool Decks in San Antoni
$14–22/sqft
Typical cost range for a new commercial pool deck pour in San Antonio
8–14wks
Average timeline from permit application to finished deck ready for use
5"
Minimum slab thickness for commercial pool decks under the City of San Antonio code
1/8"/ft
Minimum slope required to drain water away from the pool edge and toward drains

If you manage a hotel, apartment complex, HOA, or recreational facility in San Antonio, you already know that a commercial pool deck is not a weekend project. The scope alone sets it apart from residential work: larger footprints, heavier foot traffic, ADA compliance requirements, City of San Antonio permitting, and pool barrier code all need to be addressed before any concrete touches the ground.

What most property managers do not realize is that the planning phase is where most projects run into trouble. A poorly sequenced job that pulls permits after design decisions are locked in, or a concrete spec that does not account for commercial drainage requirements, can delay a project by weeks and add thousands to the final cost. This guide lays out the full process in the order it actually happens, with the specific decisions and numbers that apply to commercial pool decks in Bexar County.

The single decision that separates a smooth commercial build from a chaotic one: get the permit scope right before design is finalized

The most common cause of delays on commercial pool deck projects in San Antonio is a mismatch between what the designer specified and what the City's Development Services Department will approve. Drainage grades, barrier setbacks, ADA route widths, and expansion joint placement all need to be locked in before the concrete contractor prices the job. Starting with a contractor who knows San Antonio's commercial concrete code and who has pulled these permits before eliminates the back-and-forth that kills timelines.

● ● ●
Five phases of a commercial pool deck build in San Antonio
From first site visit to opening day what happens at each stage
01
Site assessment and concrete design
Soil testing, drainage planning, and slab specification before a shovel hits the ground
Phase 1

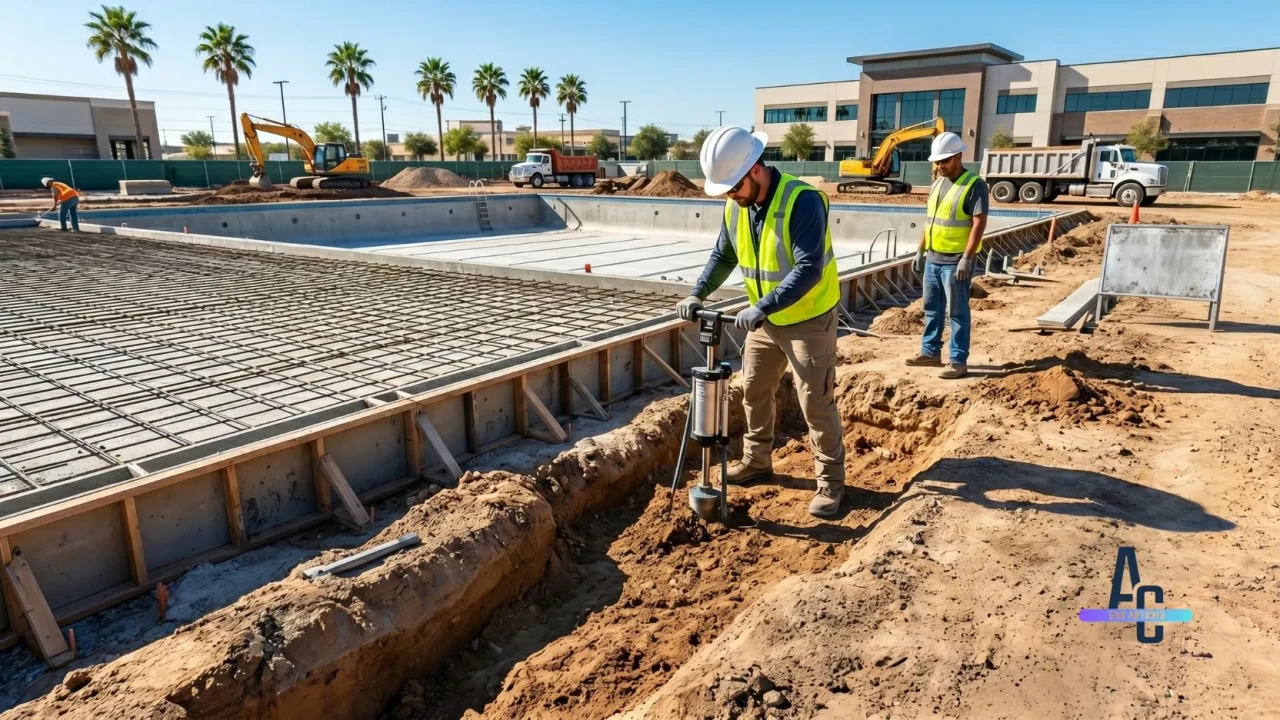

Every commercial pool deck build in San Antonio starts with a site assessment. This is not a courtesy walk-around. It is a technical evaluation that determines the concrete specification, base preparation requirements, drainage design, and the footprint boundaries that will be submitted for permitting. Skipping this step or rushing through it is the number one reason commercial projects go over budget.

New Commercial Pool Deck Build: What to Expect in SA

In Bexar County, expansive clay soils are the norm. For a residential patio, this means careful base preparation. For a commercial pool deck with heavy, concentrated foot traffic year-round, it means a full geotechnical review is strongly recommended. Soil movement in San Antonio's clay-heavy ground can crack a slab that was poured to residential spec within two to three seasons of heavy use.

Soil test: Identifies clay content, bearing capacity, and moisture risk Drainage survey: Establishes existing grade and planned drain locations Footprint boundaries: Barrier setbacks and ADA routes determined here Slab spec: Thickness, reinforcement, and expansion joint plan locked in

The concrete specification that comes out of this assessment will determine whether the project passes its City inspection on the first visit. For commercial pool decks in San Antonio, the standard spec is a 5-inch slab minimum with a rebar grid (number 4 bar at 12 inches on center both ways), poured over a 6-inch compacted crushed limestone base. Expansion joints are required at 10-foot intervals and wherever the deck meets the pool coping, any raised feature, or a building foundation.

🏗️ San Antonio drainage note: The City of San Antonio requires commercial pool decks to drain completely within a specified time after rainfall. Flat or improperly graded decks that pond water create both a liability exposure and a code violation. Every section of deck must slope a minimum of 1/8 inch per foot toward a drain or away from the pool edge. This needs to be engineered into the design before the forms are set it cannot be corrected after the pour.
Site assessment checklist
  • Soil evaluation completed: clay content, bearing capacity, and compaction requirements confirmed
  • Drainage plan designed: drain locations, slope grades, and runoff path documented
  • Pool barrier setback distances measured and recorded for permit submission
  • ADA-accessible route from entry to pool identified and dimensioned
  • Slab spec confirmed in writing: thickness, reinforcement type and spacing, base depth, and expansion joint plan
02
Permits, approvals, and code compliance in San Antonio
What the City requires, which inspections apply, and how to avoid delays
Phase 2

Commercial pool deck construction in San Antonio requires permits through the City of San Antonio Development Services Department. The specific permits required depend on the scope of work, but most new commercial pool deck builds will require at minimum a commercial building permit covering the concrete flatwork, a pool barrier inspection, and a drainage review. If the project includes any electrical (lighting, outlets), plumbing (deck drains connecting to the sanitary or storm system), or a covered structure, additional trade permits apply.

Permit or review required Who reviews it Typical timeline
Commercial building permit (flatwork) City of San Antonio Development Services 2–4 weeks after complete application submission
Pool barrier compliance Development Services / Building Inspection Reviewed with building permit; site inspection required
ADA compliance review Development Services Part of building permit plan review
Drainage and grading plan San Antonio River Authority (SARA) if near waterway; otherwise Development Services 2–3 weeks for standard review
Electrical permit (if applicable) Development Services Electrical Division 1–2 weeks; separate inspection required
Final inspection and certificate of occupancy Building Inspection Division Scheduled after all work complete; typically within 1 week of request
Permit tip

Use a contractor who has pulled commercial concrete permits in San Antonio before. The City's plan review checklist for commercial pool decks is specific drainage grades, barrier setback dimensions, ADA route widths, and expansion joint locations all need to be shown on the submitted drawings. An experienced local contractor will know exactly what the reviewer looks for and will get the application right the first time. Incomplete or incorrect applications go to the back of the queue on resubmission, adding two to four weeks to your timeline.

ADA requirements for commercial pool decks fall under the 2010 ADA Standards for Accessible Design. At minimum, this requires at least one accessible route connecting the accessible parking area to the pool entrance, a surface that is firm, stable, and slip-resistant, and turning space at any dead-end accessible route. For pool decks specifically, ADA also governs pool lift placement and the accessible route to each pool entry point. These requirements need to be reflected in the design drawings submitted with the permit application.

Permitting checklist
  • Commercial building permit application submitted with complete drawings: slab spec, drainage grades, barrier layout, ADA route
  • Pool barrier compliance documentation included: barrier height, gate hardware spec, and setback distances from water edge
  • Drainage plan stamped by engineer if required by scope or proximity to waterway
  • Trade permits identified and applied for: electrical, plumbing (deck drains), and any covered structure
  • Inspection schedule confirmed with contractor: rough slab, barrier, and final inspection dates on calendar
03
Site preparation, forming, and base installation
The work that happens before the concrete truck arrives and why it determines long-term performance
Phase 3

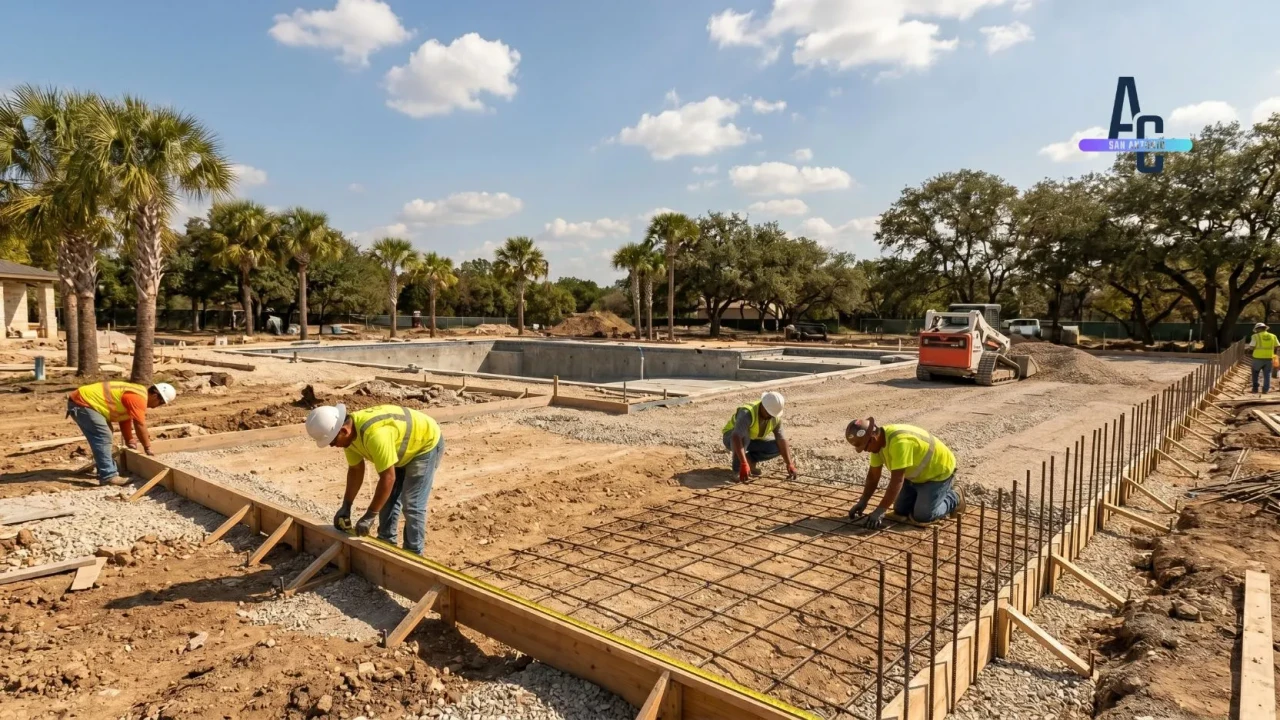

Site preparation for a commercial pool deck is the most labor-intensive phase of the project, and the one that most directly determines how long the finished slab holds up. On a well-run commercial job in San Antonio, site prep typically takes two to three days before the pour. Cutting corners here is what creates cracked, settled, or sunken commercial pool decks three to five years after installation.

New Commercial Pool Deck Build: What to Expect in SA

Excavation removes existing material to the correct depth for the base and slab combined. For a commercial pool deck in San Antonio with a 5-inch slab and 6-inch base, that means excavating to 11 inches below the finished surface grade. The excavated area is then graded to the designed drainage slope before the base material goes in.

Excavation: Remove existing material to correct depth; haul off debris Subgrade prep: Grade to drainage slope; compact native soil Base install: 6" crushed limestone placed in 3" lifts, compacted to 95% Proctor Forming: Steel or heavy lumber forms set to grade and elevation Reinforcement: Rebar grid placed on chairs at mid-slab height Sleeves and conduit: All penetrations for drains, lights, and utilities set before pour

Rebar for a commercial pool deck should be elevated on plastic or concrete chairs so that it sits at mid-slab depth not resting on the base. Rebar that sits on the ground provides little structural benefit and corrodes faster because of its proximity to moisture in the base material. For a 5-inch commercial slab, the rebar chairs should hold the grid at 2.5 inches above the base surface.

⚠️ All deck drains, conduit sleeves for electrical, and any pipe penetrations through the slab must be set and secured before the pour. It is not possible to core through a properly reinforced commercial slab after the fact without compromising structural integrity and creating a leak path at the pool surround. Get the utility coordination done during forming not after.
Site prep and forming checklist
  • Excavation depth verified: slab thickness plus base depth below finished grade
  • Native subgrade compacted before base material is placed
  • Crushed limestone base placed in two 3-inch lifts, each compacted to 95% standard Proctor density
  • Forms set to correct grade and verified for drainage slope before rebar placement
  • Rebar grid placed on chairs at mid-slab height not resting on base material
  • All drain sleeves, conduit, and utility penetrations set and secured in forms before pour day
  • Expansion joint locations marked and isolation material or foam backer placed at pool coping, building walls, and column bases
04
The commercial pour: mix spec, placement, and surface finishing
What happens on pour day for a commercial pool deck and what to watch for
Phase 4

A commercial pool deck pour in San Antonio typically requires multiple concrete trucks sequenced to arrive at intervals that allow the crew to keep up with placement and finishing. For a large commercial deck 3,000 square feet or more this can mean four to eight trucks over the course of a morning. The crew size needs to match the pour volume. An understaffed crew on a large commercial pour will struggle to finish sections properly before the concrete reaches initial set, particularly in San Antonio's summer heat.

4,000psi
min. mix
Minimum concrete mix strength for commercial pool decks in San Antonio. Standard residential concrete is typically 3,000 to 3,500 psi. Commercial pool decks see heavier foot traffic, greater thermal cycling from pool water and Texas sun, and more chemical exposure (chlorine, cleaning agents). A 4,000 psi mix with a water-reducer admixture is the correct starting point.
0.45
w/c ratio
Maximum water-to-cement ratio for pool deck concrete. Excess water weakens the mix and increases permeability both problems in a pool environment where chlorine and moisture are constant. A lower w/c ratio means a denser, more durable slab. Do not let the crew add water at the truck to make the mix easier to work with.
2–3hrs
finish window
Time window for surface finishing on a commercial pour in San Antonio summer heat. In temperatures above 95 degrees Fahrenheit, initial set can happen faster than expected. Stamped or textured finishes need to be applied within this window. Schedule pours to start at or before 7:00 a.m. during summer months to give the crew maximum working time before heat accelerates set.
3–5days
cure period
Minimum wet curing period after a commercial pool deck pour. Apply a liquid curing compound immediately after finishing, or wet-cure with soaker hoses and burlap for at least three days. In San Antonio's summer heat, the slab surface can lose moisture faster than the chemical curing reaction can proceed, resulting in a weaker surface layer that dusts and scales prematurely.

Surface finish for commercial pool decks must meet two requirements that residential work does not always prioritize: slip resistance when wet and durability under commercial-grade cleaning chemicals. The most common finishes used on commercial pool decks in San Antonio are exposed aggregate, medium broom finish, and brushed texture. Smooth trowel finishes are not permitted on exterior commercial pool decks under any conditions they are a slip hazard when wet and a liability exposure.

Finish tip

Exposed aggregate is the most durable and lowest-maintenance finish for high-traffic commercial pool decks in San Antonio. The natural texture provides excellent wet slip resistance without a surface coating that needs periodic reapplication. A sealed exposed aggregate deck also resists the chlorine and UV damage that degrades stamped and stained surfaces faster in a pool environment. For commercial properties focused on reducing long-term maintenance costs, this is typically the correct finish choice.

Pour day checklist
  • Concrete mix design confirmed: 4,000 psi minimum, water-to-cement ratio at or below 0.45
  • Truck delivery sequenced correctly: intervals match crew's placement and finishing pace
  • No water added at the truck by the driver to improve workability
  • Rebar placement verified before first truck discharges: chairs in place, grid at correct depth
  • Expansion joints cut or tooled at all planned intervals as each section is poured
  • Non-slip surface finish applied: exposed aggregate, medium broom, or brushed texture not smooth trowel
  • Curing compound applied immediately after finishing, or wet curing protocol initiated before crew leaves site
05
Inspection, sealing, and getting the deck open for use
What happens between the pour and the day guests step onto the deck
Phase 5

After the concrete cures, the project moves into final inspections before the deck can be opened to the public. For commercial pool decks in San Antonio, the City's final inspection covers the concrete flatwork, pool barrier compliance, ADA route verification, and drainage. All of these need to pass before the certificate of occupancy is issued and the pool area can be used. Scheduling the inspection early -- as soon as the 28-day cure period is complete keeps the project on timeline.

Day 1–2: No foot traffic; curing compound applied and curing process underway Day 3–7: Limited foot traffic only; no heavy equipment or furniture placement Day 28: Full cure complete; schedule City final inspection After inspection: Apply penetrating sealer; install furniture and pool equipment Opening day: Certificate of occupancy in hand; pool area open for use

Sealing a commercial pool deck is not optional. In San Antonio's combination of intense UV exposure, seasonal temperature swings, and constant chlorine exposure near the pool edge, an unsealed commercial slab will show surface scaling and color degradation within two to three seasons. A penetrating concrete sealer not a surface film sealer is the correct product for commercial pool decks. Penetrating sealers bond with the concrete matrix rather than sitting on the surface, which means they do not peel, bubble, or create a slip hazard when wet the way some topical coatings can.

📋 Commercial property note: Keep all permit documentation, inspection sign-off sheets, and the concrete mix design records on file. If the property is ever sold, refinanced, or subject to an insurance inspection, documentation that the pool deck was permitted, inspected, and built to code protects the owner. Concrete work done without a permit creates disclosure obligations and potential liability at sale particularly for commercial properties in Bexar County.
Inspection and handoff checklist
  • 28-day cure period complete before scheduling final City inspection
  • Pool barrier inspection passed: barrier height, gate self-closing hardware, and setback distances verified
  • ADA route inspection passed: surface firmness, slope, and turning space confirmed at all required locations
  • Drainage inspection passed: no standing water on deck surface after hose test
  • Penetrating sealer applied after inspection sign-off not before, as sealer can interfere with some inspection tests
  • Certificate of occupancy received and filed with property records
  • All permit documentation, inspection records, and concrete mix design receipts filed for future reference
● ● ●
Commercial pool deck cost reference San Antonio 2026
What each line item of a commercial pool deck build actually costs

Commercial pool deck costs in San Antonio vary based on deck size, finish selection, and site conditions. The table below breaks down typical cost ranges by line item so you can evaluate contractor quotes accurately and spot where bids are cutting corners.

Line item Typical cost range Notes
Excavation and haul-off $1.50–3.00/sqft Varies with depth and access; clay soil costs more to haul due to weight
Crushed limestone base (6") $1.00–2.00/sqft Material plus compaction; do not accept quotes that omit this line
Forming and rebar placement $1.50–2.50/sqft Commercial rebar grid at #4 bar is more labor-intensive than residential wire mesh
Concrete (5" slab, 4,000 psi) $5.00–7.00/sqft Material plus placement; based on ready-mix pricing in Bexar County
Surface finish broom or brushed Included in concrete line Standard commercial finish; no upcharge over plain pour
Surface finish exposed aggregate $2.00–3.50/sqft upcharge Additional labor for surface washing and aggregate reveal process
Expansion joints (tooled or saw-cut) $0.50–1.00/linear ft Saw-cut joints on commercial work are standard; tooled joints available on smaller pours
Penetrating sealer (first application) $0.50–1.00/sqft Applied after 28-day cure; silane-siloxane penetrating sealer recommended for pool environments
Permitting fees $800–2,500 per project Varies with project valuation and number of trade permits required
Total installed cost (broom finish) $14–18/sqft All-in including base, pour, finish, joints, and sealer; excludes electrical and plumbing
Total installed cost (exposed aggregate) $17–22/sqft All-in with premium finish; most common spec for new commercial pool decks in SA
● ● ●
Complete commercial pool deck build checklist
Use this before signing a contract or making a deposit on any commercial pool deck project in San Antonio
Planning and design
  • Site assessment completed: soil evaluation, drainage survey, and ADA route planning done before design is finalized
  • Slab specification confirmed in writing: 5" minimum thickness, number 4 rebar at 12" on center, 6" compacted limestone base
  • Drainage grades designed into the slab: minimum 1/8" per foot slope toward drains confirmed on drawings
  • Expansion joint plan documented: 10-foot maximum spacing, isolation joints at coping, building walls, and all penetrations
Permits and compliance
  • Commercial building permit applied for with complete drawings slab spec, drainage grades, barrier layout, ADA route
  • Pool barrier compliance addressed: barrier height, self-closing and self-latching gate hardware, and setback distances from pool edge
  • ADA compliance addressed in design: accessible route, surface requirements, and pool lift placement documented
  • All trade permits applied for: electrical (lighting), plumbing (deck drains), and any covered structure
Contractor qualification
  • Contractor has pulled commercial concrete permits in San Antonio verify with City records if uncertain
  • Certificate of insurance on file: $2M general liability minimum for commercial work; workers compensation confirmed
  • Quote itemizes every line item: excavation, base, rebar, concrete, finish, joints, sealer, and permitting fees
  • Concrete mix design included in quote: 4,000 psi minimum, w/c ratio at or below 0.45 specified
  • References from completed commercial pool deck projects in Bexar County available on request
Post-pour and handoff
  • Curing process confirmed in writing: liquid compound or wet curing for minimum 3 days after pour
  • No commercial foot traffic, furniture placement, or equipment staging for minimum 7 days
  • Final City inspection scheduled for day 28 or later after pour
  • Penetrating sealer applied after inspection sign-off; resealing scheduled for every 3 years
  • All permits, inspection records, and concrete mix design documentation filed with property records
● ● ●
Common questions answered
FAQs
Q
How long does a commercial pool deck build take from start to finish in San Antonio?
Most commercial pool deck projects in San Antonio run 8 to 14 weeks from initial site assessment to the day the deck is open for use. Permitting typically takes 2 to 4 weeks after a complete application is submitted. Site preparation and forming take 2 to 5 days depending on project size. The pour itself is usually completed in one day for decks under 5,000 square feet. The 28-day concrete cure period then follows before the final City inspection can be scheduled. Properties that try to compress the timeline by starting construction before permits are approved or by opening before the final inspection consistently run into problems either stop-work orders or failed inspections that require remediation work.
Q
Do I need a permit for a commercial pool deck in San Antonio?
Yes, without exception. Any commercial pool deck construction in San Antonio new build, full replacement, or significant repair -- requires permits through the City of San Antonio Development Services Department. Commercial properties that skip permitting create serious liability exposure: an unpermitted pool deck cannot legally be certified as ADA-compliant, the work is not covered by the contractor's permit bond, and the property owner assumes full liability for any injury that occurs on an unpermitted surface. If the property is later sold, inspected by an insurer, or subject to a code compliance review, unpermitted work will need to be remediated or permitted retroactively typically at greater cost than doing it correctly the first time.
Q
What is the best concrete finish for a commercial pool deck in San Antonio?
Exposed aggregate is the most commonly specified finish for new commercial pool decks in San Antonio, and for good reason. The natural stone texture is inherently slip-resistant when wet without any surface coating that can peel or degrade over time. It stands up to chlorine exposure, UV, and commercial pressure washing better than stamped or stained finishes. A sealed exposed aggregate deck on a properly prepared 5-inch slab should look clean and perform safely for 20 or more years with a resealing schedule every 3 years. Medium broom finish is a practical second choice for property managers prioritizing initial cost over appearance. Smooth or lightly textured trowel finishes should never be specified for commercial pool decks they are a slip hazard when wet and a liability issue.
Q
How do I evaluate competing bids for a commercial pool deck project?
The key is to compare the spec, not just the total price. Ask every bidder to provide a line-item quote that includes: slab thickness, base material and depth, rebar size and spacing, concrete mix design (psi and w/c ratio), surface finish type, expansion joint spacing and method, sealer product and application schedule, and permitting responsibility. A bid that is significantly lower than the others is almost always cutting one or more of these line items. The most common shortcuts on commercial pool deck quotes in San Antonio are a thinner slab (4 inches instead of 5), wire mesh instead of a rebar grid, omission of the compacted limestone base, and no sealer included in the scope. These omissions save the contractor money at bid time and cost the property owner far more in premature repairs.
Q
How often does a commercial pool deck need to be resealed in San Antonio?
A penetrating concrete sealer on a commercial pool deck in San Antonio should be reapplied every 3 years under normal conditions. Properties with very high foot traffic, frequent chemical applications, or aggressive pressure washing may need resealing every 2 years. A simple test: pour a small amount of water on the deck surface. If it beads and sits on the surface, the sealer is still active. If the water absorbs into the concrete within 30 seconds, it is time to reseal. Resealing is a low-cost maintenance task -- typically $0.50 to $1.00 per square foot applied that dramatically extends the life of the slab surface and prevents chlorine and moisture from penetrating the concrete matrix where they can cause internal damage over time.
